Skip to content
Construction Partner
Inventory & purchasing

See how much of every purchase order is invoiced

Each PO line is coded to a job, cost code, piece of equipment, work order, or inventory. Vendor invoices are entered against the PO lines, so the invoiced amount and the remaining balance stay current on every PO.

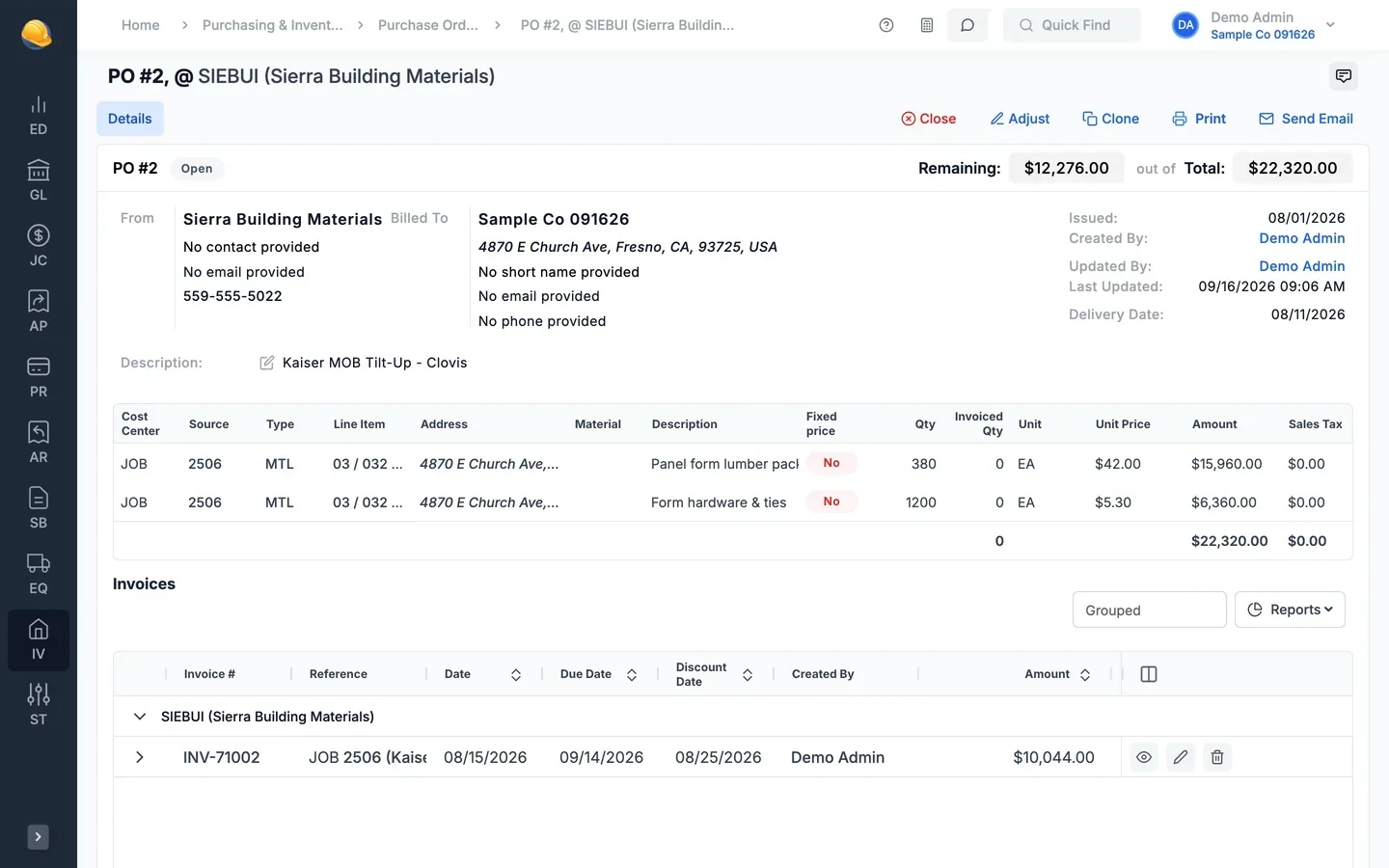

Purchase order 2 for Sierra Building Materials on job 2506: remaining $12,276 out of $22,320, two material lines, and one vendor invoice for $10,044
From order to invoice

Order, adjust, invoice, and close each PO

Purchase orders feed committed cost on the job. Invoices, adjustments, and receipts keep each PO line up to date until it closes.

  1. Purchase orders

    Purchase orders coded to the job before the material ships

    Create a PO with the vendor, delivery date, and lines coded to a job and cost code, equipment, a work order, or inventory. Pending POs go through review before they open, and open POs count as committed cost on the job.

    • Fixed price and unit price lines with sales tax and freight
    • Review and approve or reject pending purchase orders
    • Print as a purchase order or subcontract agreement and email it to the vendor
    • Clone a PO, or import purchase orders from a file

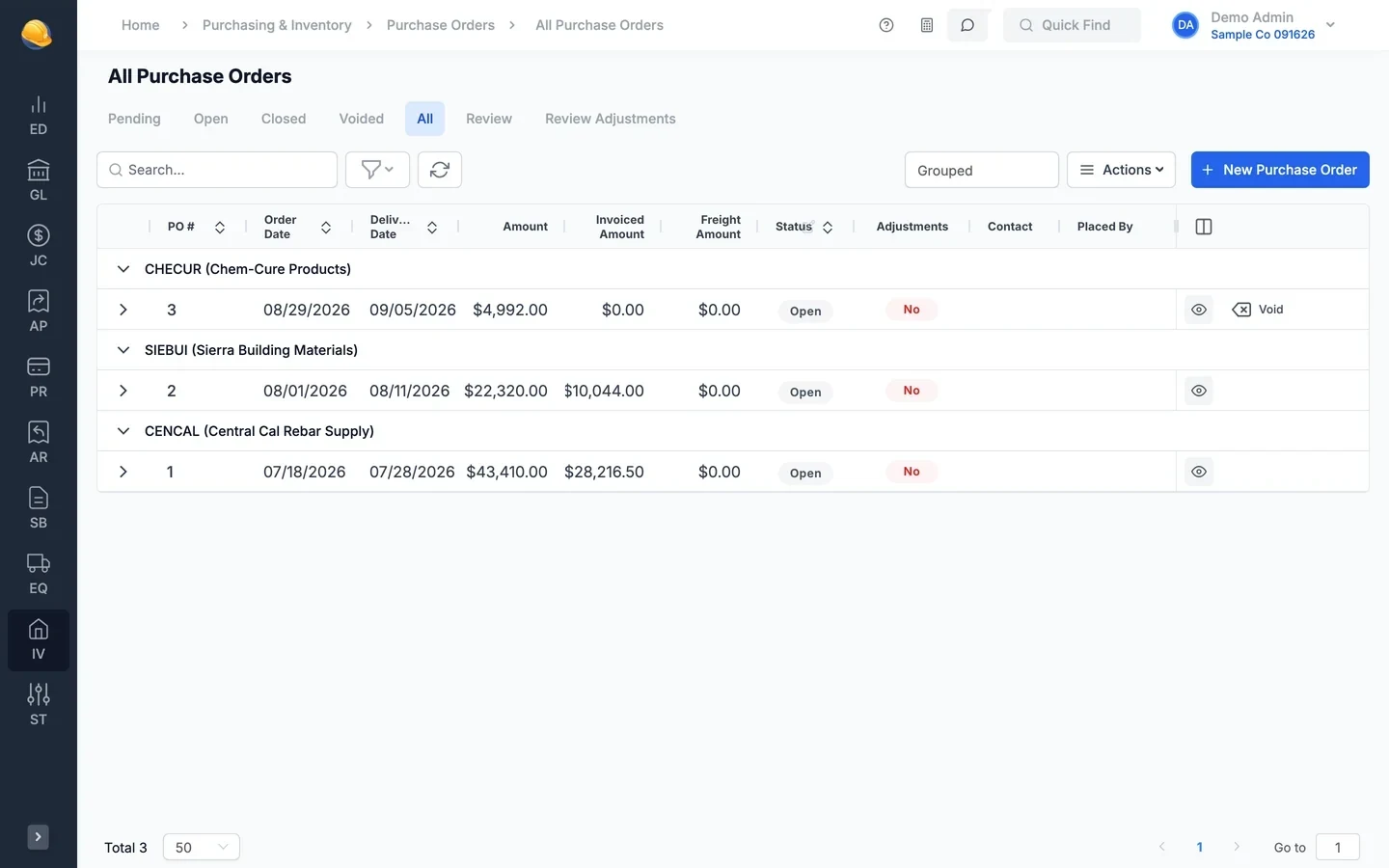

    All purchase orders grouped by vendor with order date, delivery date, amount, invoiced amount, freight, and status
  2. Invoices against POs

    Invoice the PO line by line

    Enter the PO number on a vendor invoice and pick the PO lines to bill. Each line shows what remains to invoice, and the invoice updates the invoiced quantity and amount on the PO. Close the PO when it is fully invoiced, or let it close automatically.

    • Remaining amount to invoice on each PO line
    • Hide lines that are already fully invoiced
    • Warning when an invoice goes over the PO amount
    • Voiding an invoice reopens the purchase order

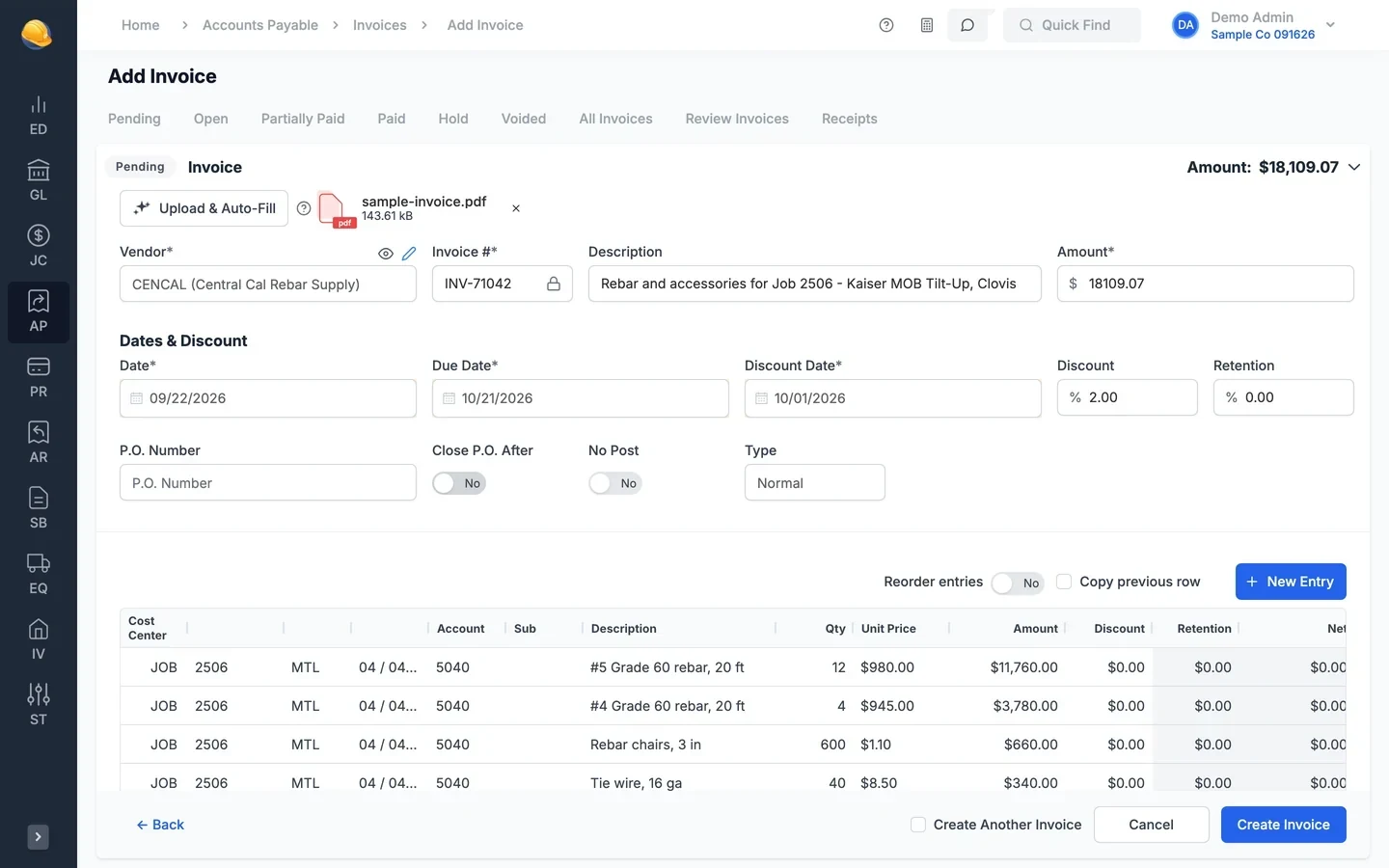

    Vendor invoice INV-71042 from Central Cal Rebar Supply entered with PO number 2, its rebar lines coded to job 2506 material, for $18,109.07
  3. PO adjustments

    Change orders on purchase orders

    Add, change, or remove PO lines with a PO adjustment. The summary shows the amount, tax, and freight before and after, and an adjustment cannot take a line below what has already been invoiced. Posted adjustments update committed cost on the job.

    • Add new lines, update quantities and prices, or delete uninvoiced lines
    • Before and after totals for amount, tax, and freight
    • Review and approve adjustments before they post
    • Print a change order agreement for the vendor

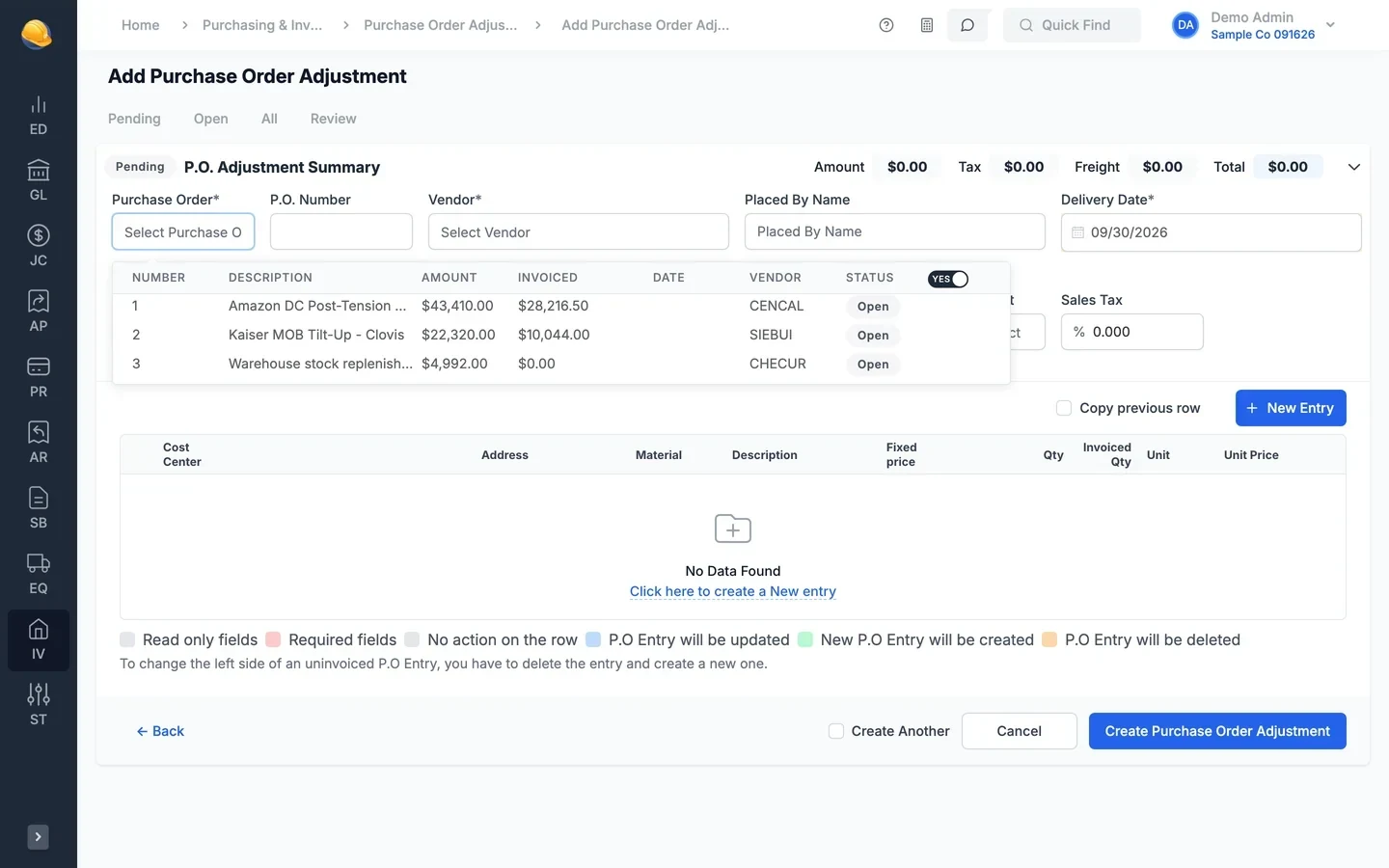

    Add purchase order adjustment: purchase order picker listing open POs with amount, invoiced amount, vendor, and status, plus the adjustment summary
  4. Budget tracking

    See how much of each job budget is already spent or on order

    The job dashboard puts the budget, actual cost, and variance by cost type next to the open purchase orders on the job. The job budget vs. committed report shows, line by line, what is still left to buy, so you know whether the budget covers the next order.

    • Budget, actual, and variance by cost type on the job dashboard
    • Open purchase orders on the job with amount and invoiced to date
    • Purchase order invoice detail with invoiced to date and retention
    • Budget vs. committed report with the budget left to buy by line item

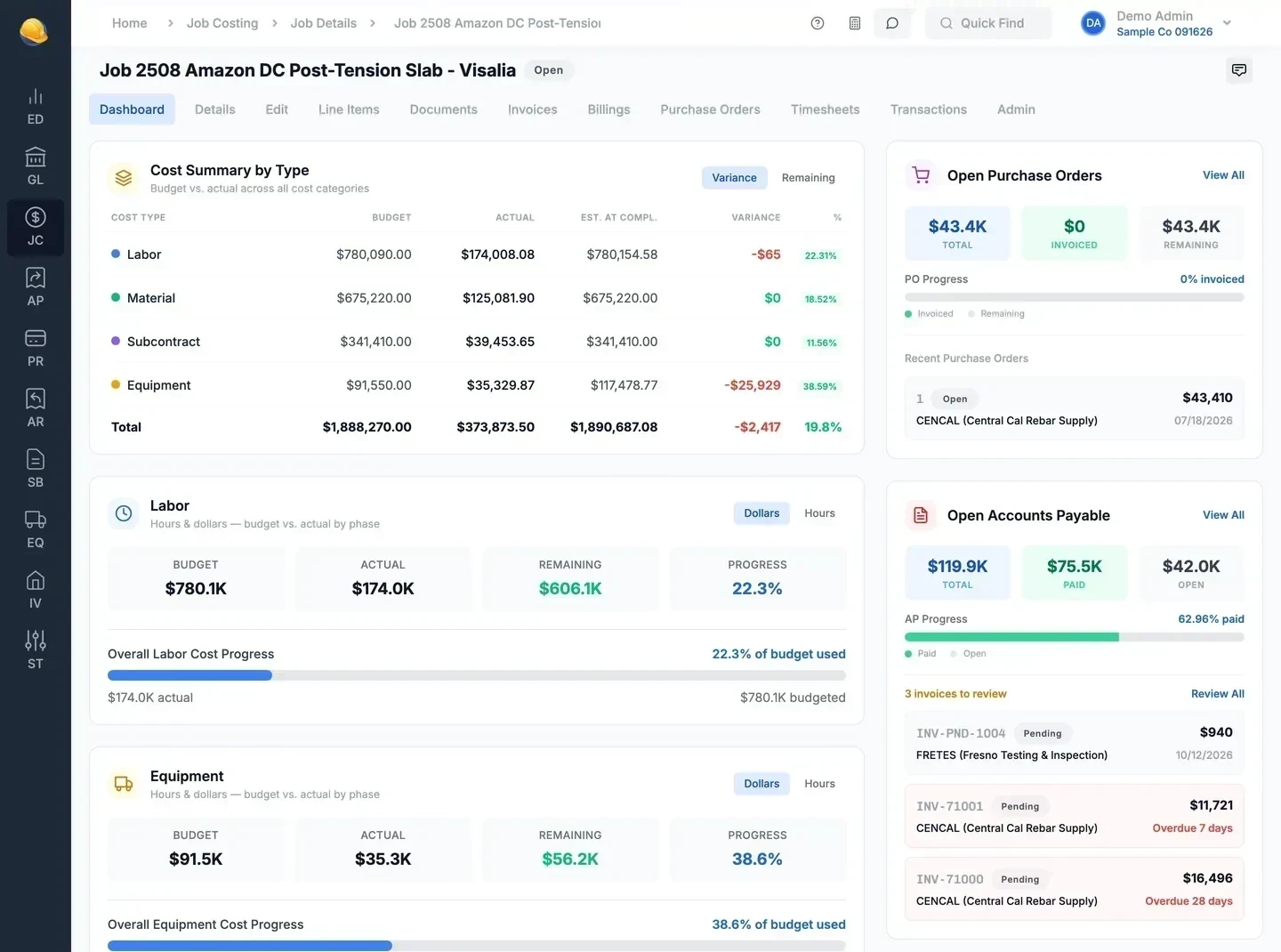

    Job 2508 dashboard: cost summary by type with budget, actual, and variance, labor and equipment progress, open purchase orders with amount and invoiced to date, and open payables
  5. Materials & inventory

    Materials with cost, on hand, and on order

    Keep a material list with class, unit, standard cost, and vendors. Material bought for inventory shows as on hand and on order, and a transfer to cost of goods sold moves it to the job, piece of equipment, or work order that used it.

    • Standard, average, last PO, or last invoice price for charge-out
    • Receive material against open PO lines, with the packing slip number
    • Inventory adjustments and transfers to jobs, equipment, or work orders
    • Inventory history listing and inventory trial balance

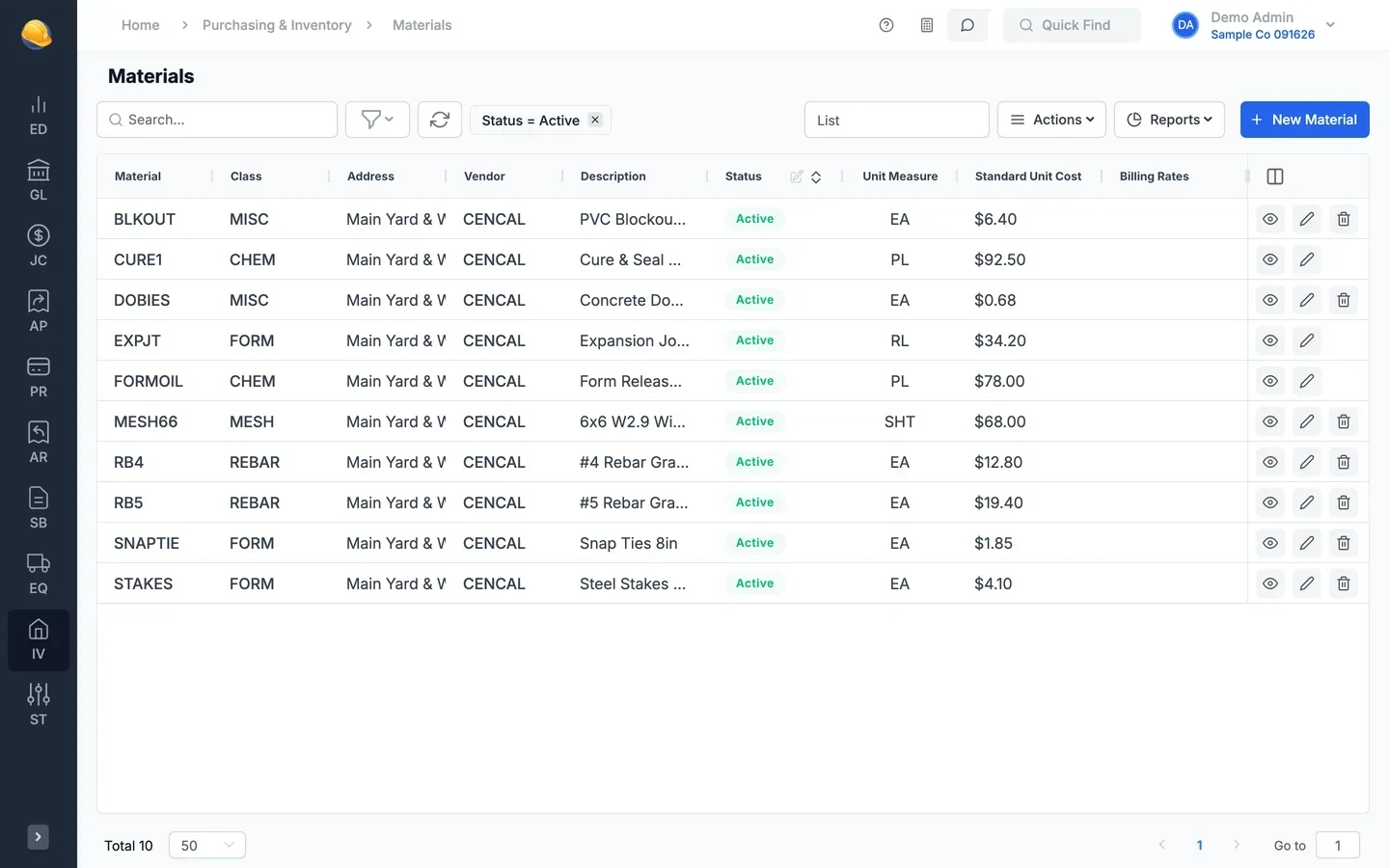

    Materials list: blockouts, cure and seal, dobies, expansion joint, form release, wire mesh, rebar, snap ties, and stakes with class, vendor, unit, and standard unit cost

What's inside

Job-coded purchase orders

Each PO line coded to a job and cost code, a unit, a work order, inventory, or overhead.

PO approvals

Review pending purchase orders and approve or reject them with a reason.

Subcontract agreements

Print a PO as a subcontract or change order agreement.

Email to vendors

Send the purchase order to the vendor from the PO.

Invoiced and remaining

Invoiced quantity and amount on each PO line, updated as invoices post.

Auto close

Close a PO when it is fully invoiced, or close them in bulk.

PO adjustments

Change orders that add, update, or remove PO lines.

AI invoice scanning

Scanning a vendor invoice PDF reads the PO number printed on it.

Material list

Class, unit, conversion factor, standard cost, and vendors per material.

Receiving

Receive material against open unit price PO lines.

Transfers to COGS

Move material from inventory to jobs, equipment, or work orders.

Reports

PO listing, budget vs. committed, PO invoice detail, materials, inventory history, trial balance.

Import your open purchase orders and material list

Bring in purchase orders and materials from CSV or Excel files, so committed cost is right from the first day.
